Vital railway upgrades to continue in New Year on the Southend Victoria line: Structure installation at Billericay

Thursday 16 Nov 2017

Vital railway upgrades to continue in New Year on the Southend Victoria line

Region & Route:
Eastern: Anglia
| Eastern

Work on the next phase of a £46m programme that will transform travel on the Southend Victoria branch line will take place on weeknights from January to May in the New Year as part of Network Rail’s Railway Upgrade Plan.

The work to reduce delays and improve reliability on this part of the railway will begin on 15 January 2018 between Shenfield and Hockley. This will affect services from 9:30pm on weeknights from Monday to Thursday each week for a five-month period. Weeknight closures will fast-track the programme by one year, so that passengers will benefit from the upgrades earlier.

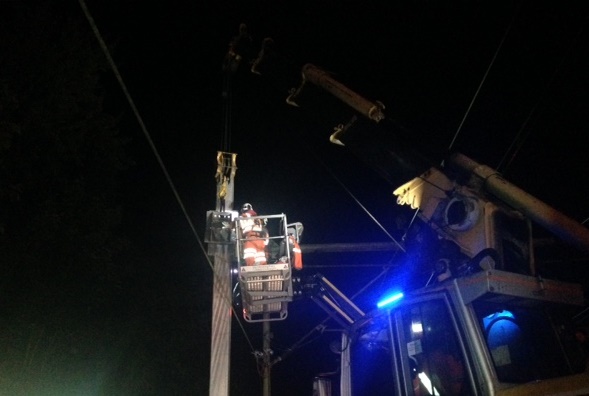

Over the last year, engineers have installed over 100 structures that will carry new overhead wires and between Shenfield and Southend Victoria and over 1km of overhead wire between Shenfield and Billericay. This marks the start of work to install 128km of overhead wire on the whole line to reduce delays caused by sagging overhead wires.

The wires and structures that are currently in place form a system that is one of the oldest in the country, having been installed in the 1950s. When the weather gets hot, the old wires expand and sag and speed restrictions have to be imposed to protect them from damage by trains, leading to delays and cancellations. The new wires are controlled by a system of weights to keep them taut at all times, so trains can travel at their normal speed, meaning fewer delays and more reliable services all year round.

The work can only be carried out when no trains are running, which means services will be affected after 9:30pm Monday – Thursday from 15 January. Work will also take place between Southend Victoria and Shenfield on weekends throughout January. Passengers are advised to check before they travel at www.greateranglia.co.uk or www.nationalrail.co.uk.

Meliha Duymaz, Network Rail’s route managing director for Anglia, said: “This work will bring crucial improvements to our Southend passengers as part of our Railway Upgrade Plan. The new wiring system will reduce delays on this line, especially in the hot summer months, and weeknight closures will enable us to complete this work quickly so passengers will benefit sooner. I understand that closing the railway is inconvenient and I’d like to thank passengers for their patience while we carry out this important work.”

Jamie Burles, Greater Anglia managing director said: “We are working with Network Rail to make a railway for now and for future generations. We are sorry that customers are inconvenienced by this work, but combined with the brand new trains we’re getting from 2019, it will transform journeys on the Southend Victoria line. We know our customers would rather stay on the train until they reach their destination, but we will still make sure they can complete their journey, even if part of it is by bus.”

Notes to Editors

Service information

Weeknights Monday - Thursday

As a result of overhead line renewal works, all lines will be closed between Shenfield and Hockley, and between Wickford and Southminster from 22.25 each evening from Monday to Thursday.

From 23.55, all lines will be closed between Shenfield and Southend Victoria and between Wickford and Southminster.

The last through train services will be the 21.35 Liverpool Street to Southend Victoria and the 21.30 Southend Victoria to Liverpool Street services.

The last trains between Wickford and Southminster will be the 20.56 Wickford to Southminster and the 21.31 Southminster to Wickford.

After this time, buses will replace trains as follows:

From 22.25, buses will replace trains between Shenfield and Hockley/ Southminster connecting into/ out of main line services at Shenfield. From 23:55, buses will replace trains between Shenfield and Southend Victoria/ Southminster, connecting into/ out of main line services at Shenfield, with the exception of the following services:

  • The 00.15 and 00.50 Liverpool Street to Southend Victoria services will not run. Passengers for Southend should travel on the 00.18 Liverpool Street to Colchester and 00.50 (retimed from 00.46) Liverpool Street to Colchester and change at Shenfield for bus replacement services forward to Southend and intermediate stations.
  • The 22.30 and 23.00 Southend Victoria to Liverpool Street will operate as a bus service from Hockley to Liverpool Street, including intermediate stations.

The work will not take place when West Ham United play at home so train services will run on those days.

Weekends

All lines will be closed between Shenfield and Southend Victoria / Southminster all day on Saturdays and Sundays throughout January (excluding Sunday 7 January).

Buses will replace trains between Shenfield and Southend Victoria / Southminster on the following dates:

  • Saturday 6 January
  • Saturday 13 January
  • Sunday 14 January
  • Saturday 20 January
  • Saturday 27 January

Buses will replace trains between Southend Victoria / Southminster and Newbury Park (London Underground Tube Station) on the following dates:

  • Sunday 21 January
  • Sunday 28 January

Passengers for local stations into London should use the bus service to Shenfield and then TfL services for onward travel. Passengers for London should use the bus service to Newbury Park where tickets will be accepted on the Central Line to/from London Liverpool Street.

Passengers are advised to check before they travel at www.greateranglia.co.uk

Contact information

Passengers / community members
Network Rail national helpline
03457 11 41 41

Latest travel advice
Please visit National Rail Enquiries

Journalists
Network Rail press office - Katie Mack
Media relations manager (Anglia route)
0330 8577 132
Katie.Mack@networkrail.co.uk

About Network Rail

We own, operate and develop Britain's railway infrastructure; that's 20,000 miles of track, 30,000 bridges, tunnels and viaducts and the thousands of signals, level crossings and stations. We run 20 of the UK's largest stations while all the others, over 2,500, are run by the country's train operating companies.

Usually, there are almost five million journeys made in the UK and over 600 freight trains run on the network. People depend on Britain's railway for their daily commute, to visit friends and loved ones and to get them home safe every day. Our role is to deliver a safe and reliable railway, so we carefully manage and deliver thousands of projects every year that form part of the multi-billion pound Railway Upgrade Plan, to grow and expand the nation's railway network to respond to the tremendous growth and demand the railway has experienced - a doubling of passenger journeys over the past 20 years.
