Sussex passenger awareness campaign steps up ahead of nine-month Brighton Main Line Improvement Project: 501068 NR BrightonML Facebookv3 ThreeBridges 1200x630

Monday 13 Aug 2018

Sussex passenger awareness campaign steps up ahead of nine-month Brighton Main Line Improvement Project

Region & Route:
| Southern
  • 'Drop-by’ sessions being held at over 30 stations to inform passengers of upcoming planned closures
  • Campaign featuring iconic Brighton seagull will see information reaching passengers via social media
  • Passengers advised to check upcoming closure dates that will affect their journeys as soon as possible

Passengers travelling on the Brighton Main Line over the next nine months are being urged to check if their journey will be affected by a major programme of improvement works designed to reduce delays and provide better journeys for passengers between the south coast and the capital.

A public awareness campaign has been launched by Network Rail, which will be carrying out the improvements, and train operator Govia Thameslink Railway (including Southern, Thameslink and Gatwick Express), to raise awareness of the dates when the line will be closed between Three Bridges and Brighton and between Three Bridges and Lewes.

Starting today (Monday, 13 August) ‘drop-by’ sessions will be held at 34 stations across East and West Sussex advising passengers about their journey options during the line closures. A digital awareness campaign featuring a familiar Brighton seagull will see information appearing in passengers’ social media newsfeeds, while a dedicated website – www.BrightonMainLine.co.uk – will enable passengers to find out how the closures affect their journeys.  Other traditional advertising methods are also being used to make sure that the widest possible audience is reached.

From September this year through to May 2019, the railway will be closed for a total of 34 days to enable Network Rail engineers to carry out the first major overhaul of the southern end of the Brighton Main Line in more than thirty years. Most of these closures take place during weekends to minimise overall disruption to passengers, with the exception of an extended nine-day closure in February 2019, which includes the school half-term when passenger numbers are lower. This will enable engineers to complete the work without the need for significant further weekend closures and means passengers will benefit sooner from a more reliable railway.

Mark Killick, Network Rail’s Chief Operating Officer for the South East route, said: “Passengers on the Brighton Main Line deserve a better, more reliable railway and our work over the next nine months will deliver that. We know that closing the railway to carry out improvement work has a big impact on passengers’ lives, which is why we’ve worked hard to plan the work in a way that minimises overall disruption as much as possible.

“We’re working closely with Govia Thameslink Railway, Transport Focus and passenger groups to make sure the travelling public get the best possible service during our improvement programme. We'll be out and about at stations across Sussex in the weeks and months ahead to talk directly to passengers and make sure everyone knows how to plan ahead.”

Keith Jipps, Govia Thameslink Railway’s Infrastructure Director, said: “We want to minimise the disruption our customers will experience during the works so we’re informing passengers through our stations, trains, the media and social media to enable them to make the most informed decisions possible about their travel. Network Rail’s work is essential to give our passengers the reliable, punctual services that we all want on our route and my aim is make sure everyone benefits as quickly and painlessly as possible from that.”

About the Brighton Main Line Improvement Project

Network Rail’s improvement work will focus on four Victorian-era tunnels – Balcombe, Clayton, Patcham and Haywards Heath – and the railway which runs through them. A major programme to stem leaks into the tunnels and provide reliable drainage away from the tracks will take place, while sections of the track, third rail power system and signalling will be replaced or upgraded. Elsewhere, track will be renewed, sets of points, which enable trains to switch between tracks, will be replaced and fencing will be improved to deter trespassers.

The £67m investment is part of a £300m government-funded programme to boost infrastructure resilience and reliability on the busiest routes in the south east. It will reduce delays on the line by around 15% when complete, meaning better and more reliable journeys for passengers.

Dates of planned closures

Weekend travellers are being advised to plan ahead around several weekend closures which will take place on 8 September, all weekends in October and 3, 10, 24-25 November in 2018.

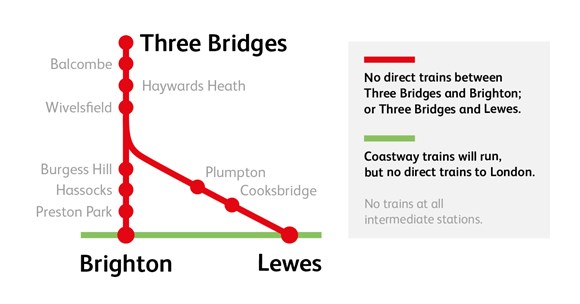

501068 NR BrightonML Facebookv2 Map 1200x630


In 2019, there will be closures on 6 January and 9-10 February before the planned nine-day closure from 16-24 February and then weekend closures on 2, 23 and 30 March, 6 April and a final one day closure on 5 May.

During these closure periods, no trains will run between Three Bridges and Brighton or between Three Bridges and Lewes. Rail replacement buses will be in operation, as well as diverted trains between London and Brighton via Littlehampton. Passengers should allow considerably more time for their journeys during these periods.

Notes to Editors

Notes to Editors:

To sign up for free alerts and to find out more about the work – including the dates of planned weekend closures – go to www.brightonmainline.co.uk. News and information will also be shared on Twitter, @brighton_line.

The closure dates in detail are as follows:

Dates

Sat

Sun

8-9 Sept 2018

Closed

-

15-16 Sept

-

-

22-23 Sept

-

-

29-30 Sept

-

-

6-7 Oct

Closed

Closed

13-14 Oct

Closed

Closed

20-21 Oct

Closed

Closed

27-28 Oct

Closed

Closed

3-4 Nov

Closed

-

10-11 Nov

Closed

-

17-18 Nov

-

-

24-25 Nov

Closed

Closed

1-2 Dec

-

-

8-9 Dec

-

-

15-16 Dec

-

-

22-23 Dec

-

-

29-30 Dec

-

-

2019

-

-

5-6 Jan

-

Closed

12-13 Jan

-

-

19-20 Jan

-

-

26-27 Jan

Closed

Closed

2-3 Feb

-

-

9-10 Feb

Closed

Closed

16-24 Feb

Closed for Feb Half term (including weekdays)

2-3 March

Closed

Closed

9-10 March

-

-

16-17 March

-

-

23-24 March

Closed

-

30-31 March

Closed

Closed

6-7 April

Closed

Closed

13-14 April

-

-

20-21 April

-

-

27-28 April

-

-

4-5 May

-

Closed



The ‘Drop-By’ sessions will be held at the following stations on the following date (subject to late amendment):

Station

Date of Drop-By Session



(Mornings 6-9am, Afternoons 4.30-7.30pm)

Aldrington

13 August

Fishersgate

13 August

Hassocks

14 August

Burgess Hill

14 August

Durrington-on-sea

15 August

Goring-by-sea

15 August

Balcombe

16 August

Plumpton

16 August

East Worthing

17 August

Portslade

17 August

Eastbourne

20 August

Shoreham-by-sea

20 August

West Worthing

20 August

Lewes

30 August

Moulescoomb

21 August

Polegate

21 August

Haywards Heath

22 August

Wivelsfield

22 August

Preston Park

22 August

Southwick

22 August

Three Bridges

23 August

London Road

23 August

Angmering

24 August

Littlehampton

24 August

Newhaven Town

3 September

Seaford

3 September

Brighton

27 August

Brighton

28 August

Hove

29 August

Worthing

21  August

Lancing

31 August

Falmer

31 August

Hampden Park

3 September

Pevensey & Westham

3 September

Collington

3 September

Bexhill

3 September

Contact information

Passengers / community members
Network Rail national helpline
03457 11 41 41

Latest travel advice
Please visit National Rail Enquiries

Journalists
Paul Dent-Jones
paul.dent-jones@networkrail.co.uk

About Network Rail

We own, operate and develop Britain's railway infrastructure; that's 20,000 miles of track, 30,000 bridges, tunnels and viaducts and the thousands of signals, level crossings and stations. We run 20 of the UK's largest stations while all the others, over 2,500, are run by the country's train operating companies.

Usually, there are almost five million journeys made in the UK and over 600 freight trains run on the network. People depend on Britain's railway for their daily commute, to visit friends and loved ones and to get them home safe every day. Our role is to deliver a safe and reliable railway, so we carefully manage and deliver thousands of projects every year that form part of the multi-billion pound Railway Upgrade Plan, to grow and expand the nation's railway network to respond to the tremendous growth and demand the railway has experienced - a doubling of passenger journeys over the past 20 years.
