World-first Severn Tunnel upgrade completed on vital rail link between South Wales and England: Severn Tunnel meets Severn Estuary - drone shot 2026

Tuesday 9 Jun 2026

World-first Severn Tunnel upgrade completed on vital rail link between South Wales and England

Region & Route:
Wales & Western: Wales & Borders

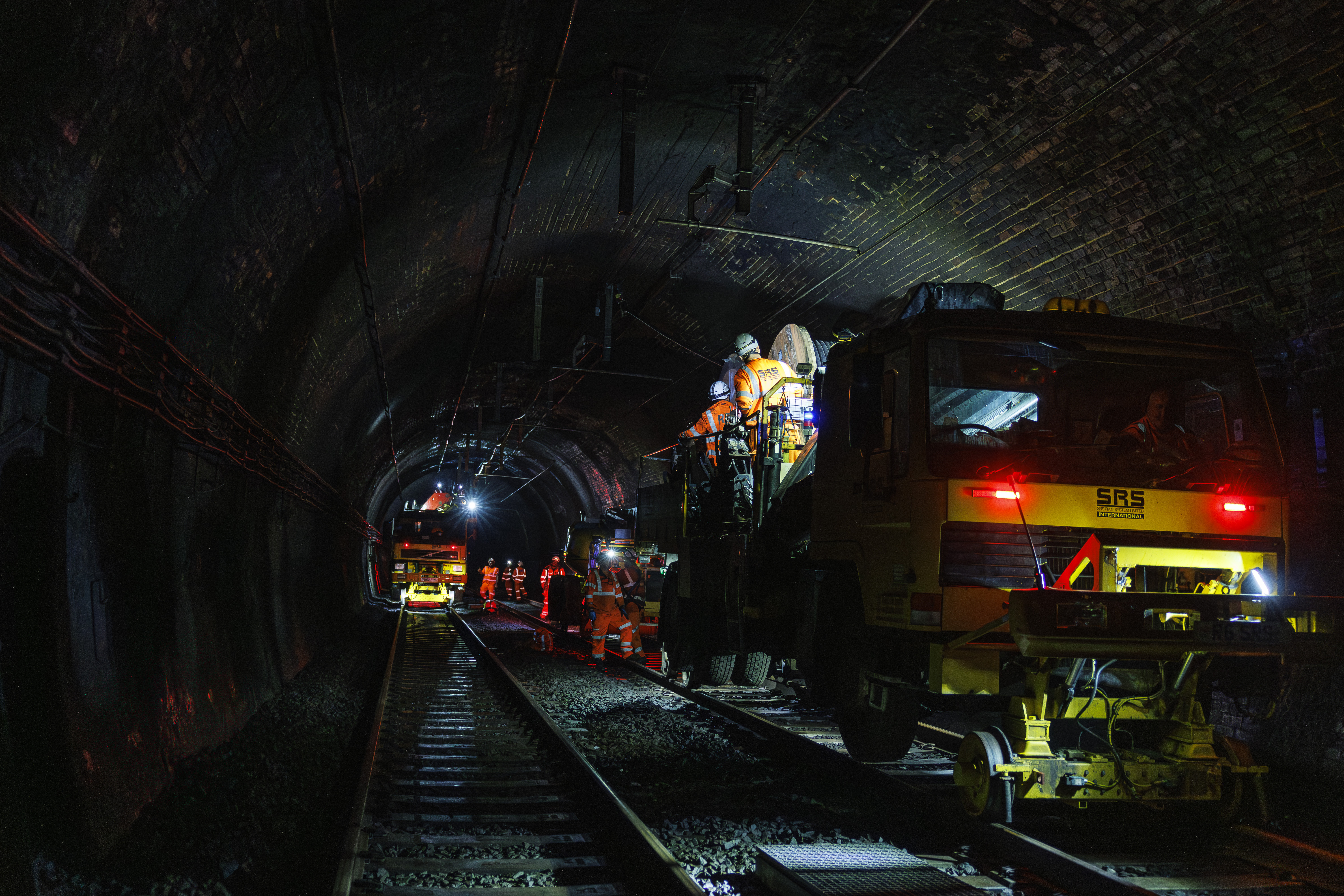

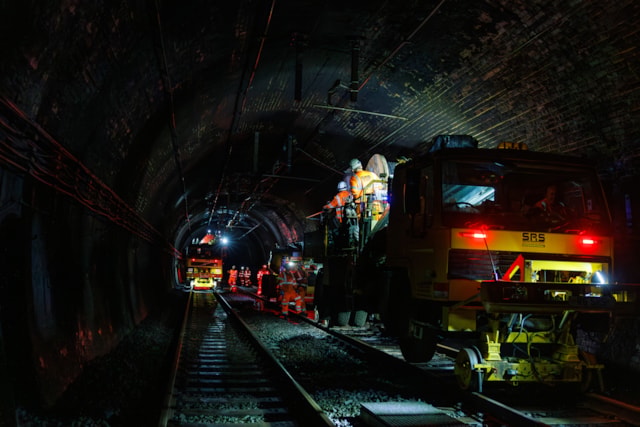

Train services are running through the Severn Tunnel once again after Network Rail completed a pioneering £23 million upgrade designed to improve reliability on one of Britain's most important cross-border rail routes.

Over 16 days, Network Rail and its contractor ARQ (AmcoGiffen, REL and QTS) have completed a pioneering upgrade to the overhead line equipment and power supply inside the Severn Tunnel, helping to improve reliability on one of the UK's most important cross-border rail routes.

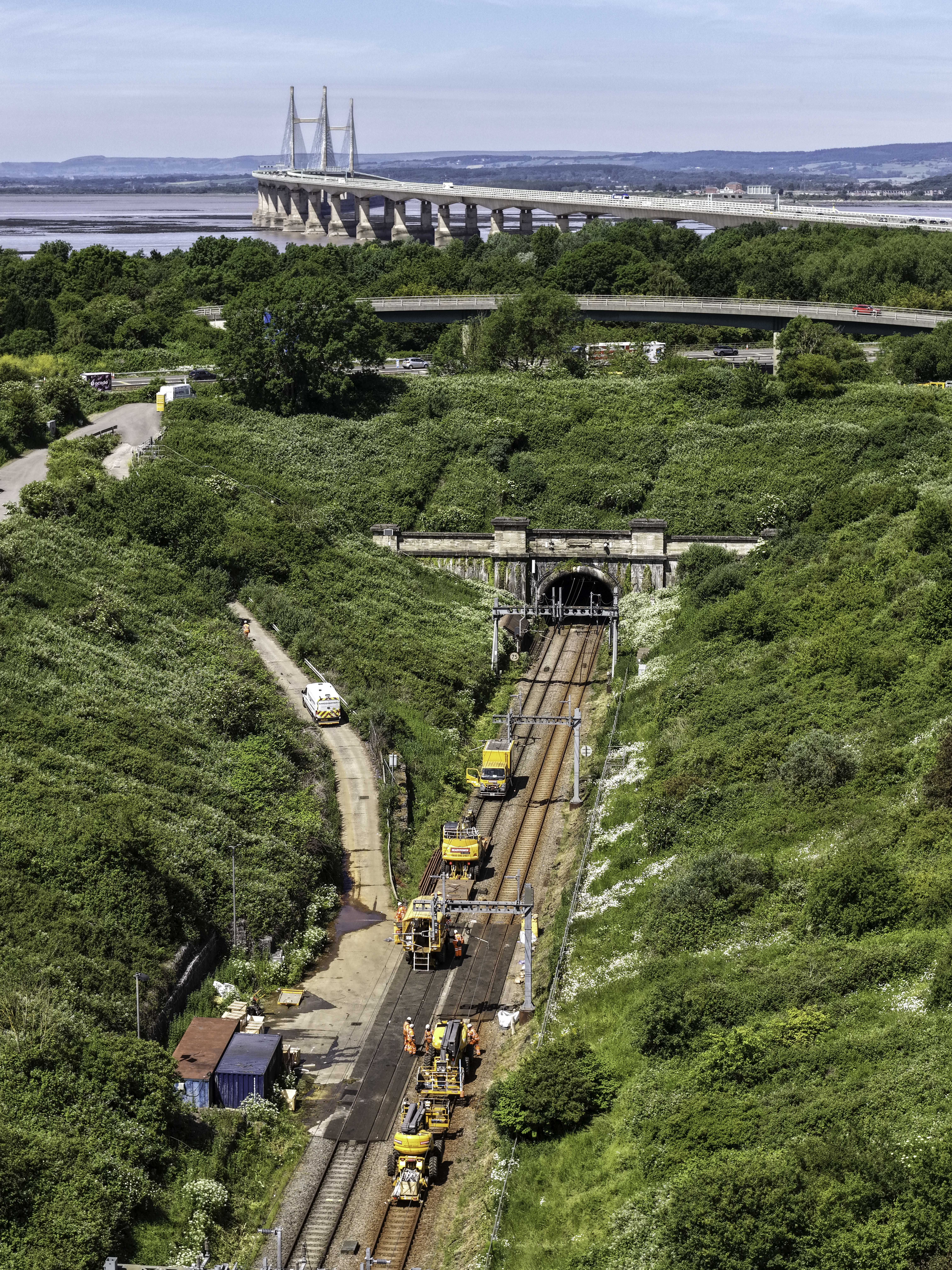

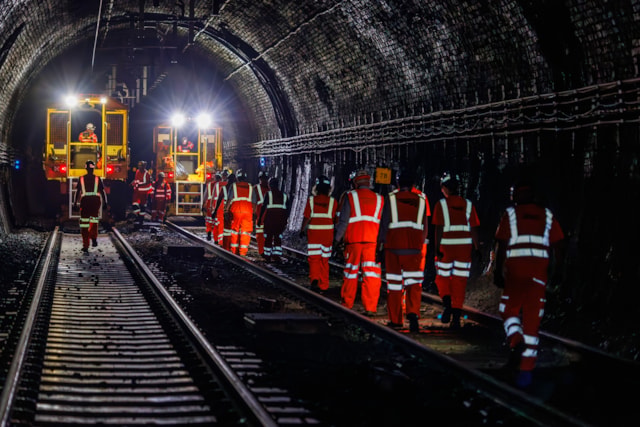

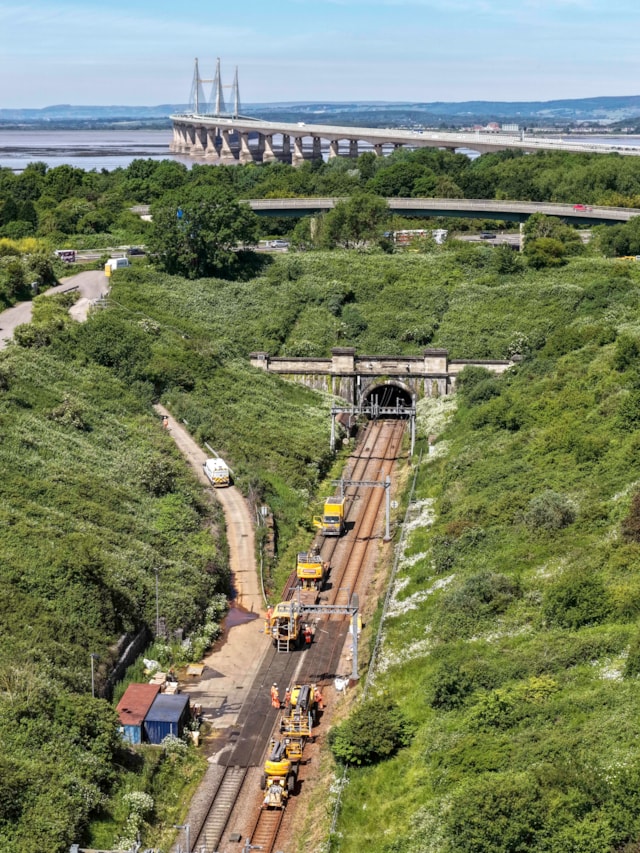

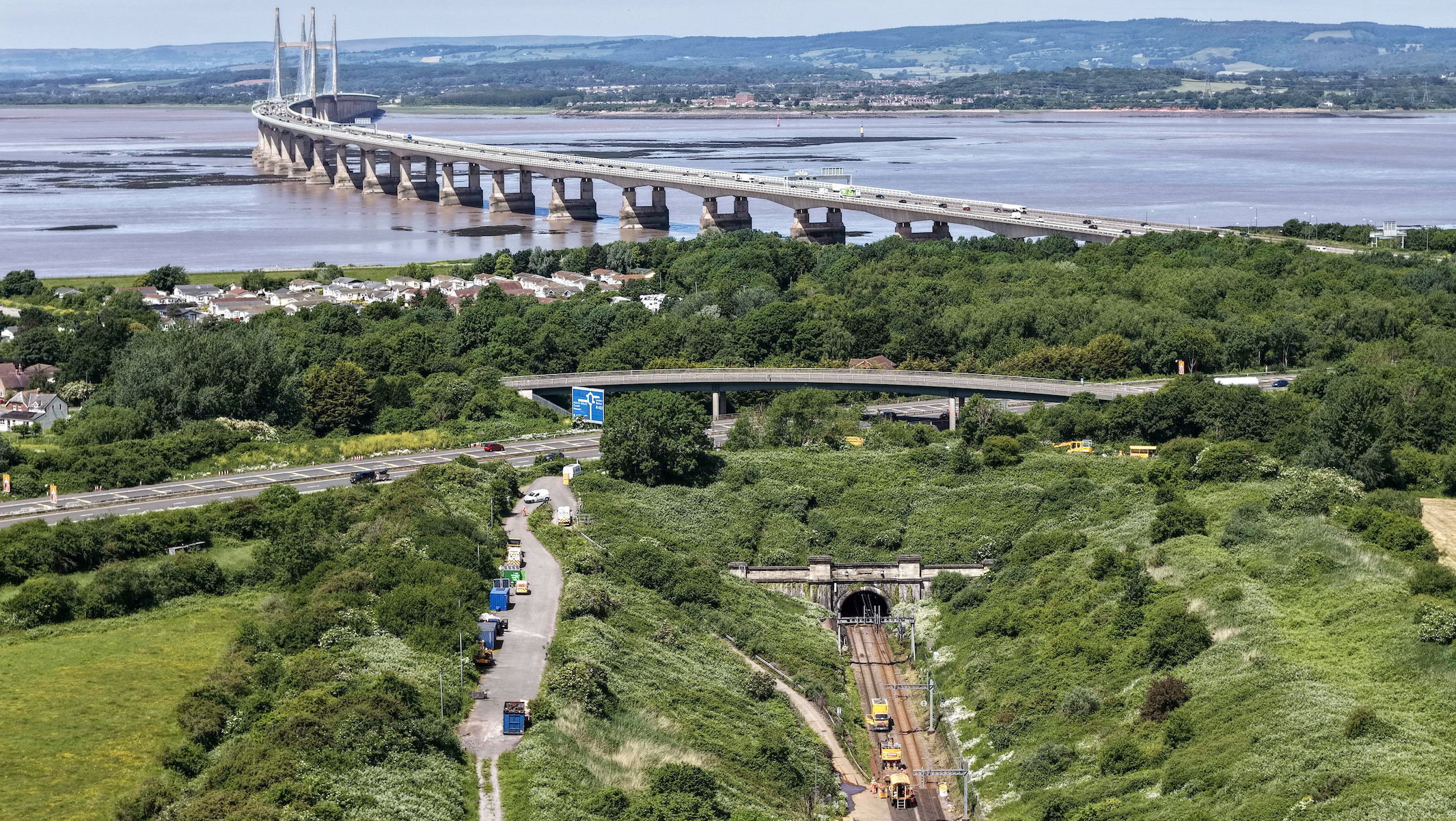

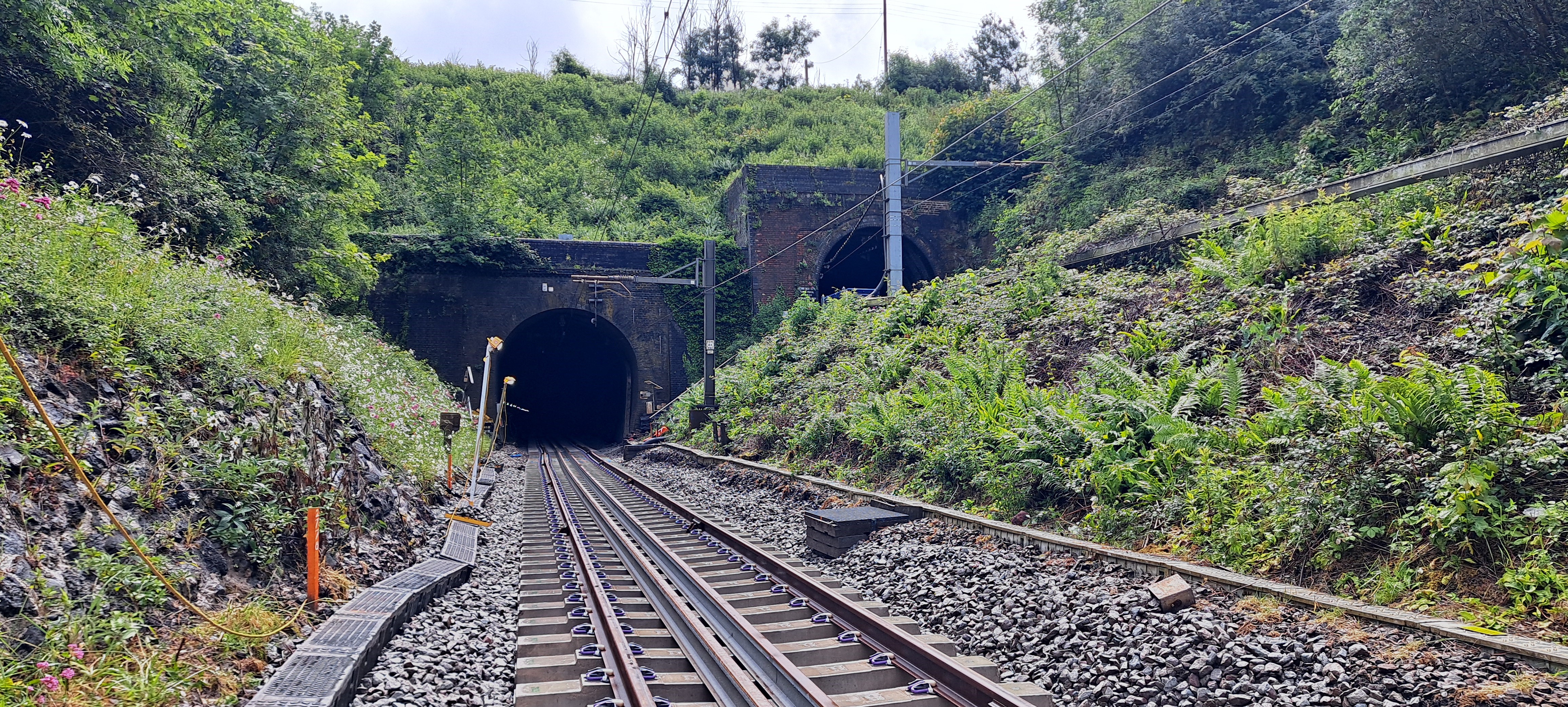

The work marks the successful completion of a world-first engineering solution inside the 4.35-mile tunnel beneath the Severn Estuary, where a unique combination of saltwater, moisture and a highly corrosive atmosphere creates one of the most challenging environments on the UK rail network. Around 250 engineers worked around the clock, from 23 May, to deliver this innovative transformation, with the railway reopening on Tuesday 9 June.

A world-first solution

The Severn Tunnel is one of the most challenging environments on the UK rail network. Since electrification, its unique combination of saltwater and moisture has accelerated wear on overhead line equipment through bi-metallic corrosion, where different metals react in wet, salty conditions and deteriorate more quickly.

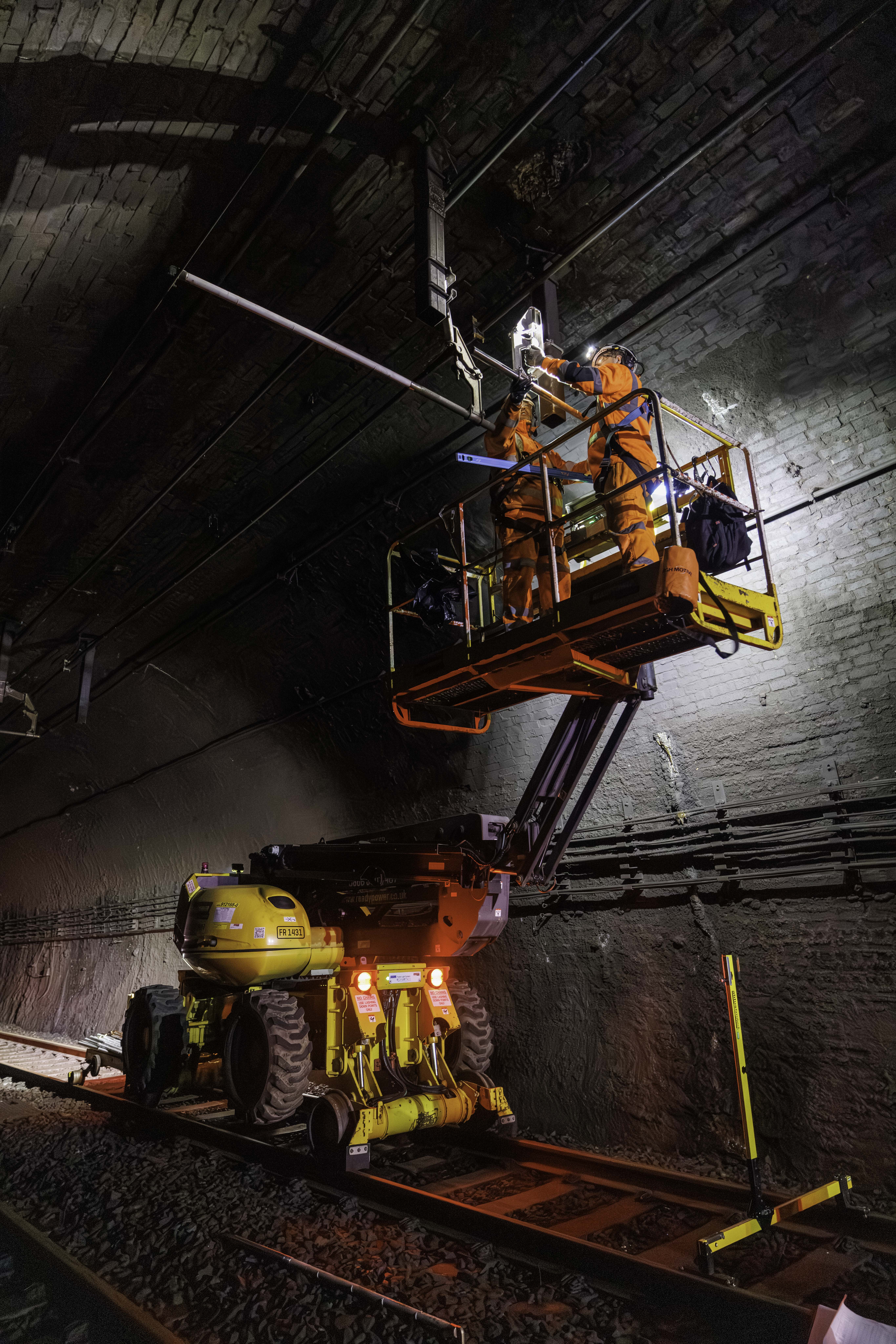

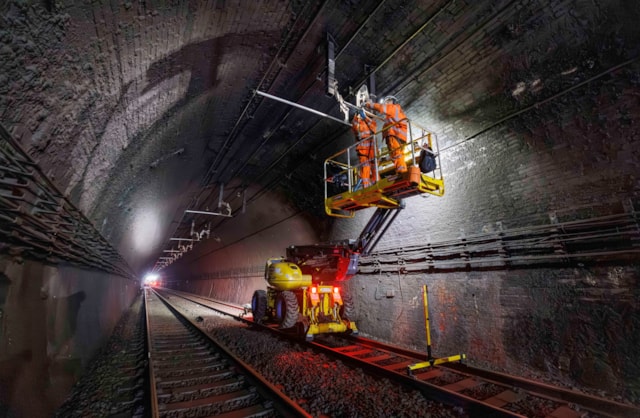

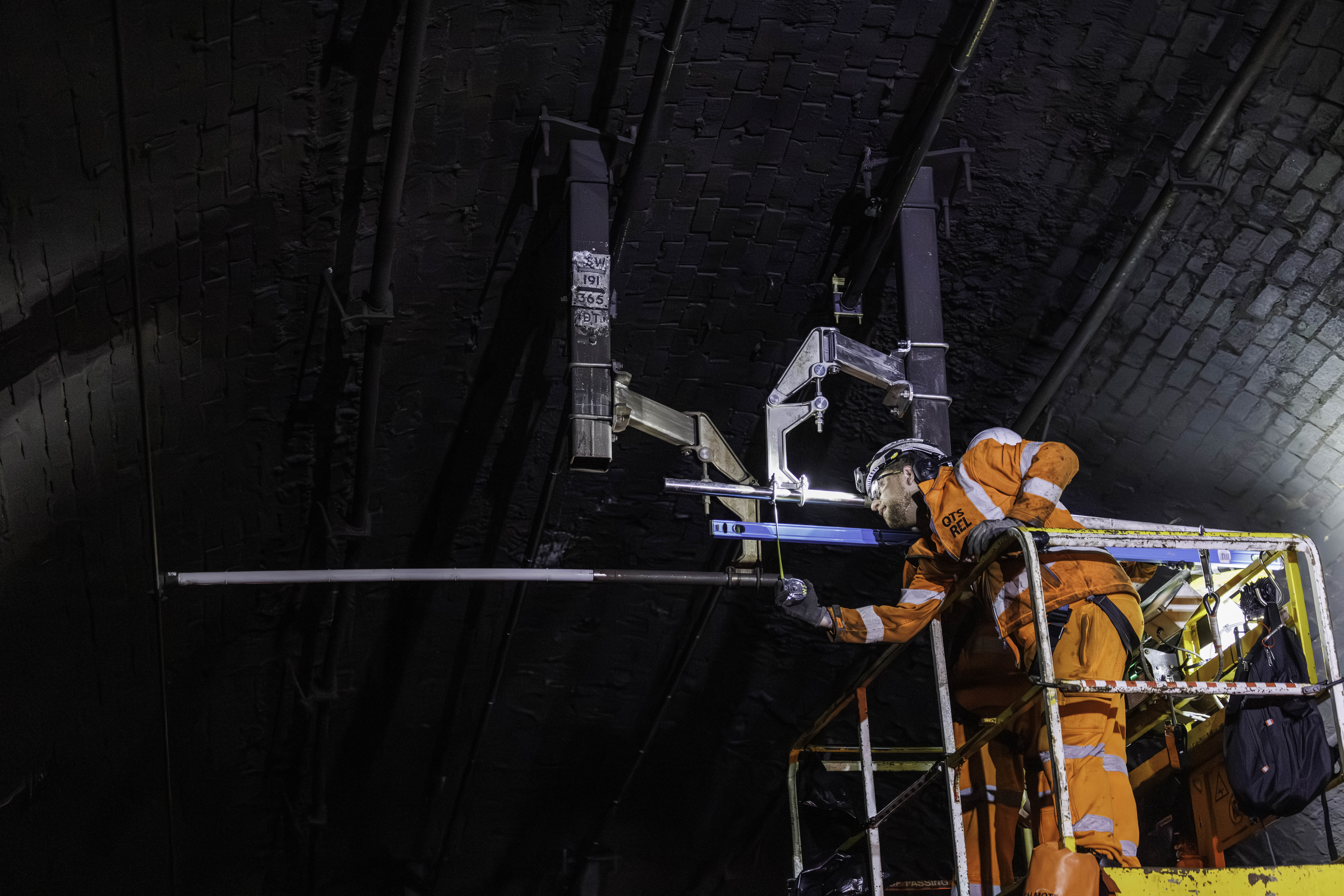

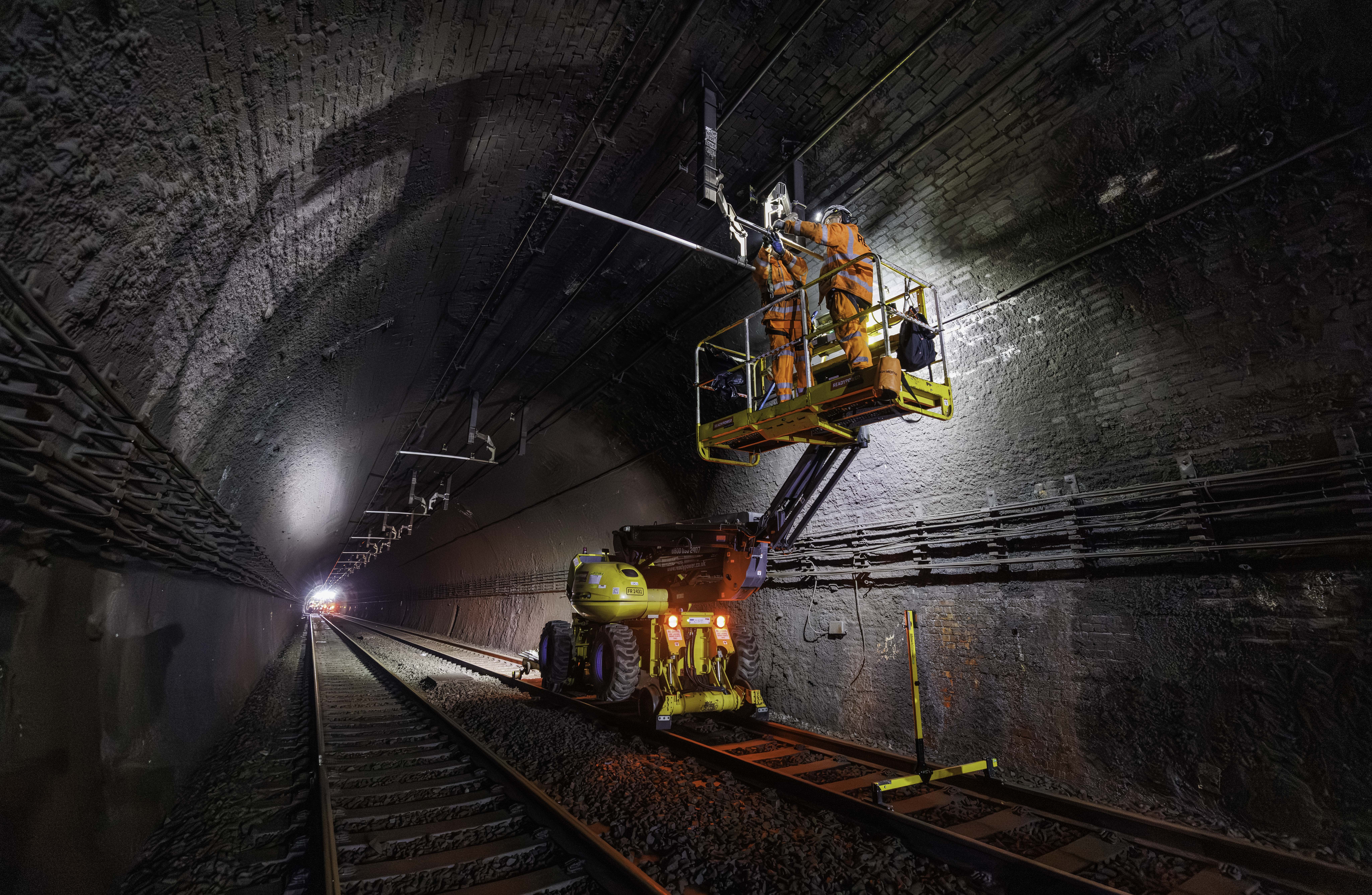

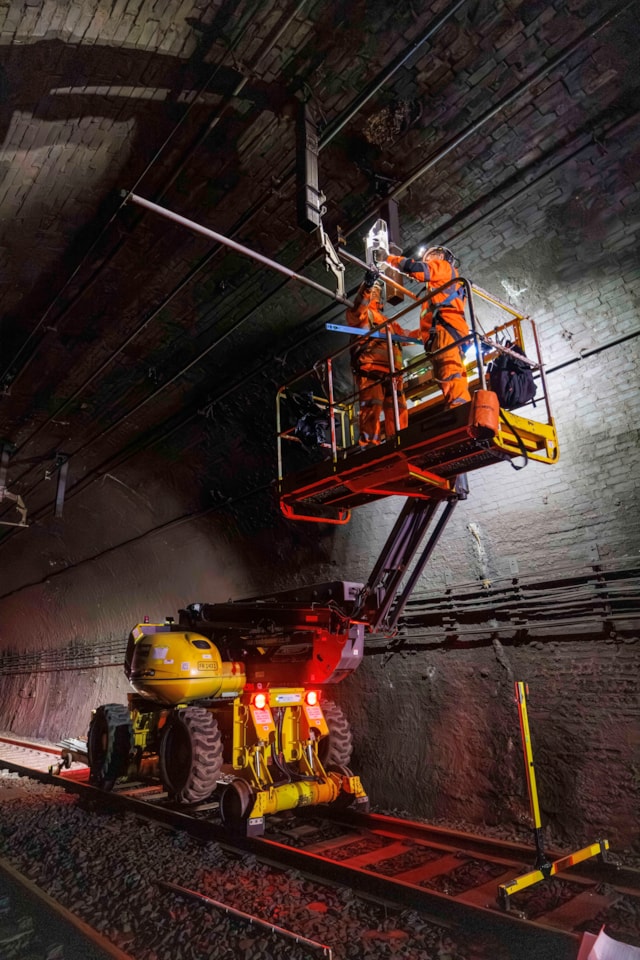

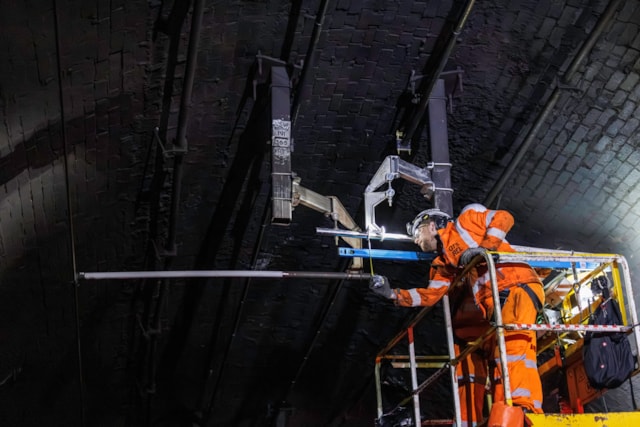

To address this long-standing challenge, Network Rail developed an innovative new overhead line system specifically designed for the tunnel's harsh environment. Backed by a £23 million investment, the simplified design uses modified bridge arms and a continuous copper contact wire to create a more resilient and reliable railway while reducing future maintenance requirements.

Following a successful trial on the Cardiff-bound line in 2025, teams from Network Rail, and contractor ARQ, have now completed the installation on the Bristol-bound line, delivering the first large-scale deployment of the system anywhere in the world.

The project included:

  • Replacing 838 overhead line support arms
  • Installing 14,000 metres of new wiring
  • Installing more than 7km single copper contact wire supported by modified bridge arms
  • Removing and replacing 7,200 metres of ageing equipment throughout the tunnel

The pioneering upgrade will help improve reliability for passenger and freight services travelling through the tunnel, strengthening a vital rail link between South Wales and England for years to come.

Nick Millington, Route Director at Network Rail Wales and Borders, said: "The Severn Tunnel is one of the most challenging environments anywhere on the UK rail network, so completing this upgrade is a significant achievement for everyone involved.

"Following a successful trial last year, we've now delivered a world-first engineering solution at scale, designed specifically to withstand the uniquely harsh conditions inside the tunnel. This is the result of years of innovation, planning and collaboration between Network Rail and our industry partners to solve a long-standing challenge on a vital rail link between South Wales and England.

"Investing in innovative solutions like this helps us build a more resilient and reliable railway for the future. By reducing the impact of corrosion and the need for maintenance, this new system will help keep passengers and freight moving on a route that plays a crucial role in connecting communities, supporting businesses and driving economic growth on both sides of the border.

"I'm incredibly proud of the hundreds of colleagues and contractors who worked around the clock to deliver this complex upgrade safely and successfully. I'd also like to thank passengers, freight operators and local communities for their patience and understanding while we carried out this essential work."

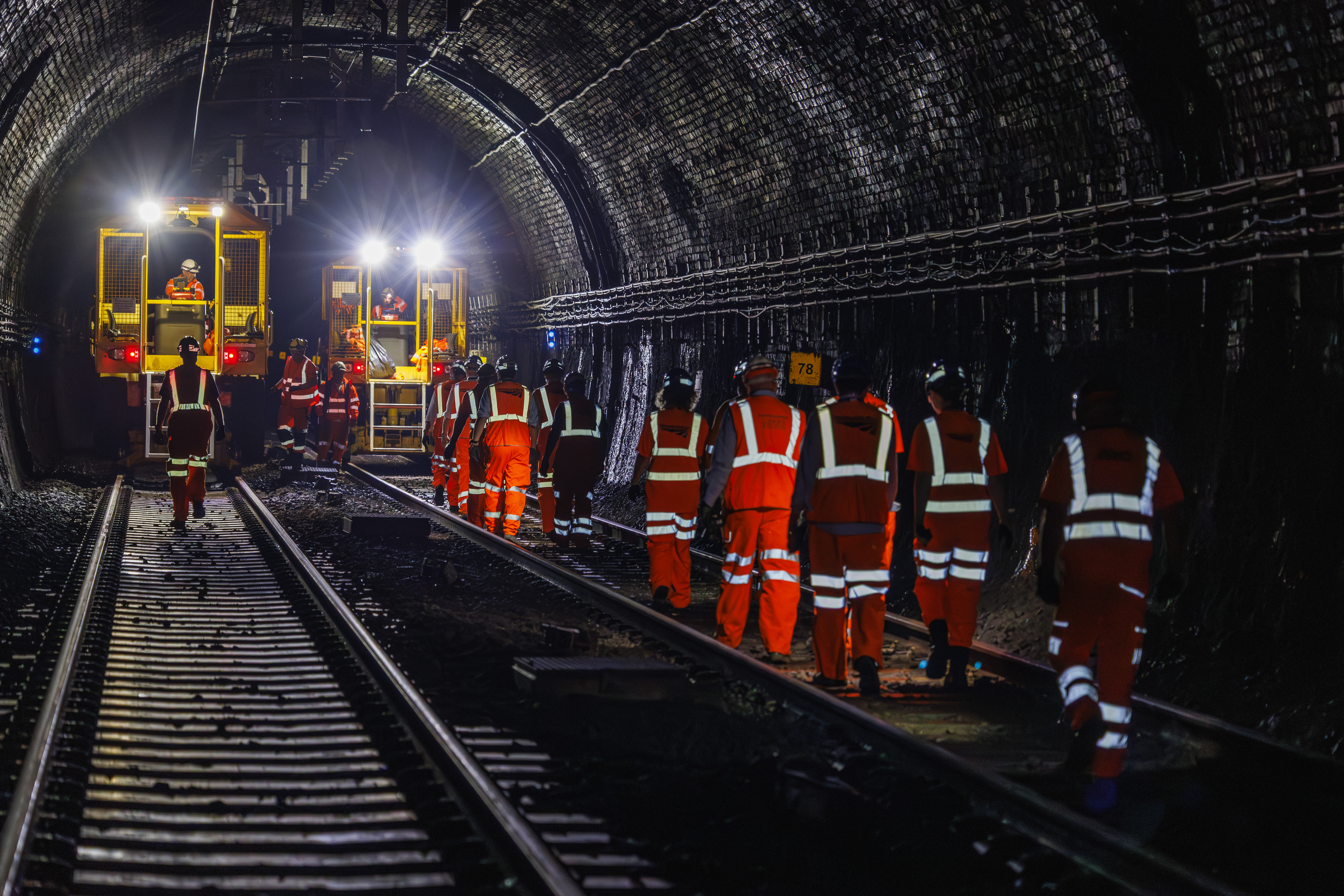

Vinny O’Holloran, Operations Director for ARQ, said: “It’s been great to see the level of effort and commitment of our 250 strong engineering and delivery team working tirelessly 24/7 for the past 16 days to deliver this vital overhead line renewal in the Severn Tunnel safely and efficiently.

"From working in the extreme heat, to overcoming the uniquely challenging conditions within the Severn Tunnel, our teams have shown outstanding resilience, skill and professionalism to successfully deliver this innovative, world‑first Overhead Line system.

"These essential works will help to create a stronger, more resilient rail infrastructure between Wales and England reducing future disruption to passengers and freight."

GWR’s Station Manager for Bristol Parkway and Swindon, Marcus Deegan, said: “We’re pleased that trains are now running again between Bristol and South Wales, and we’d like to thank customers for their patience while this important work has been carried out.

 “These improvement works help support the reliability of trains using the Severn Tunnel route for years to come, better supporting the local and national economy."

Further upgrades delivered in Bristol

Alongside the Severn Tunnel upgrade, engineers used the railway closure to deliver a range of significant improvements across the Bristol area, to boost reliability and support future passenger growth across the Great Western route.

Tackling flooding and improving resilience

Engineers carried out major drainage improvements between Patchway and Pilning, replacing nearly 200 metres of pipe, refurbishing a further 700 metres, and upgrading 18 inspection chambers.

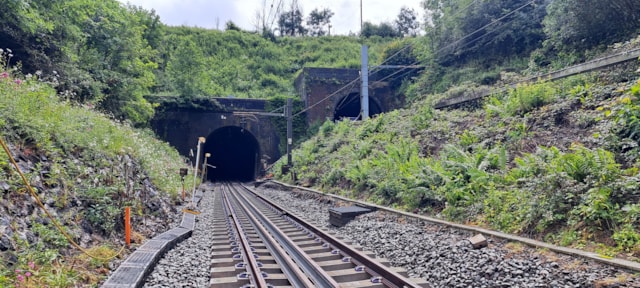

This work is vital in addressing long-standing flooding issues, particularly in the Bristol-bound Patchway tunnel, where water has previously led to speed restrictions.

Further drainage upgrades are planned in the coming months on the Filton West Chord, supporting the return of regular passenger services on the Henbury line this autumn - for the first time since 1964.

Upgrading track for smoother journeys

Alongside drainage work, more than 1.5 kilometres of track has been renewed in the area.

Inside the confined space of the Patchway tunnel, teams replaced over half a kilometre of track, installing 742 new sleepers and 1,800 tonnes of ballast.

A further kilometre of track was renewed between Filton and Patchway, using 2,045 sleepers and 3,000 tonnes of ballast. Engineers also renewed the junction at Filton West Curve, and completed track work on the Filton West Chord, which will enable the return of passenger services to the Henbury line this autumn.

Bristol Brabazon

At the new Bristol Brabazon station, built on the former Filton Airfield site, teams reached another key milestone.

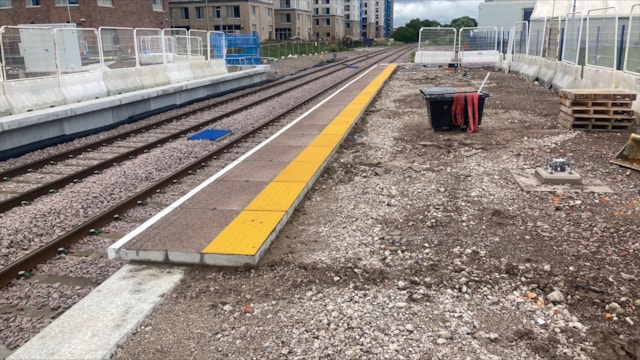

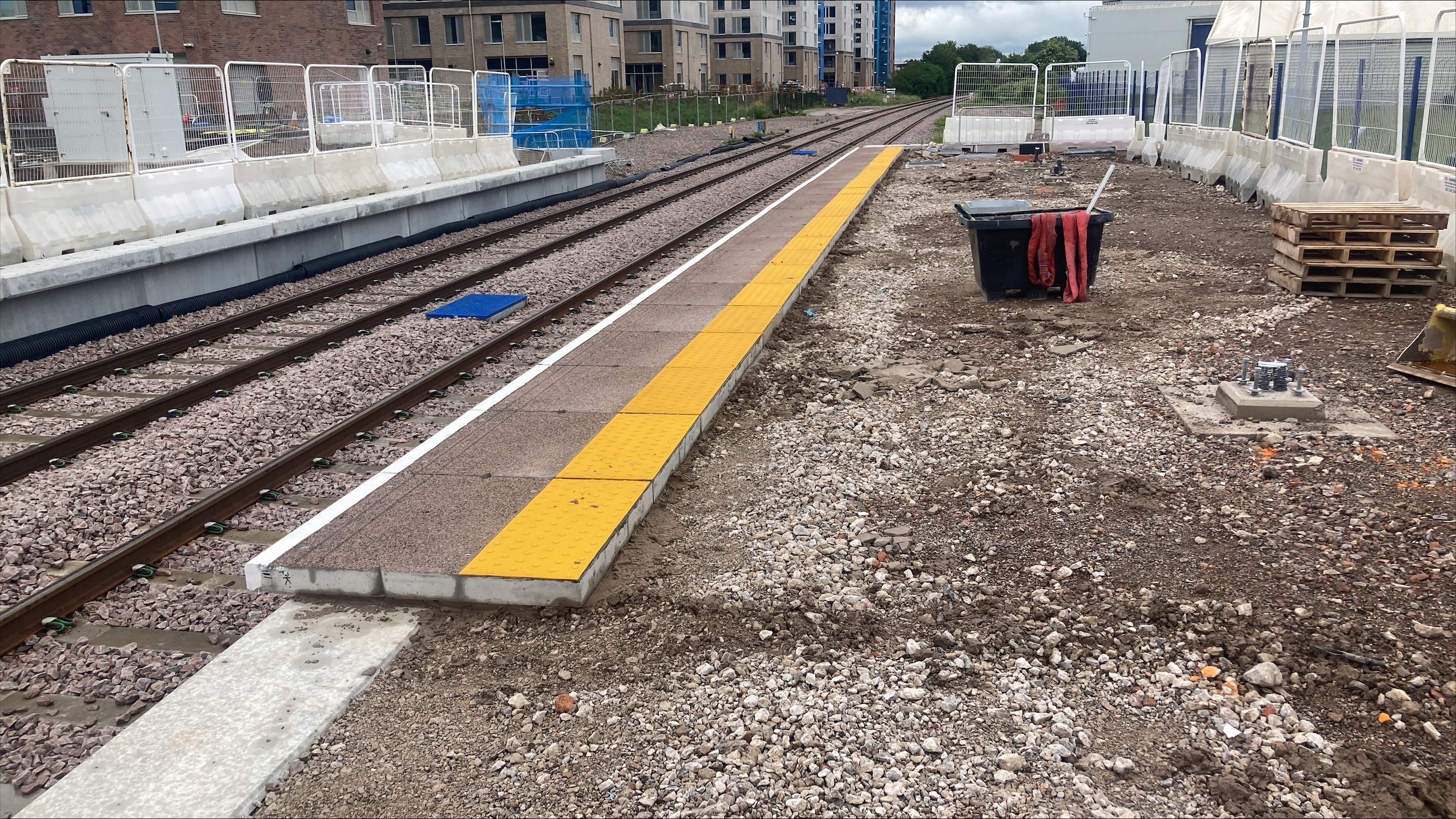

A nine-piece footbridge was successfully installed using cranes and assembled on site within 24 hours. Work has also progressed on platform construction, including the installation of coping stones along the platform edge.

The new Bristol Brabazon station is mainly funded by the West of England Mayoral Combined Authority, with contributions from South Gloucestershire Council, Bristol City Council, North Somerset Council and Great Western Railway, with Network Rail as a key partner.

Construction will continue over the coming weeks as the project remains on track for the station to open this autumn.
