Longest tunnel closure since Victorian-era improves West Coast main line journey times: Kilsby tunnel new sleepers

Monday 18 May 2020

Longest tunnel closure since Victorian-era improves West Coast main line journey times

Region & Route:
North West & Central
| North West & Central: West Coast Mainline South

A fortnight’s work on a Victorian-built railway tunnel is now complete to improve future journey times for passengers and freight on the West Coast main line.

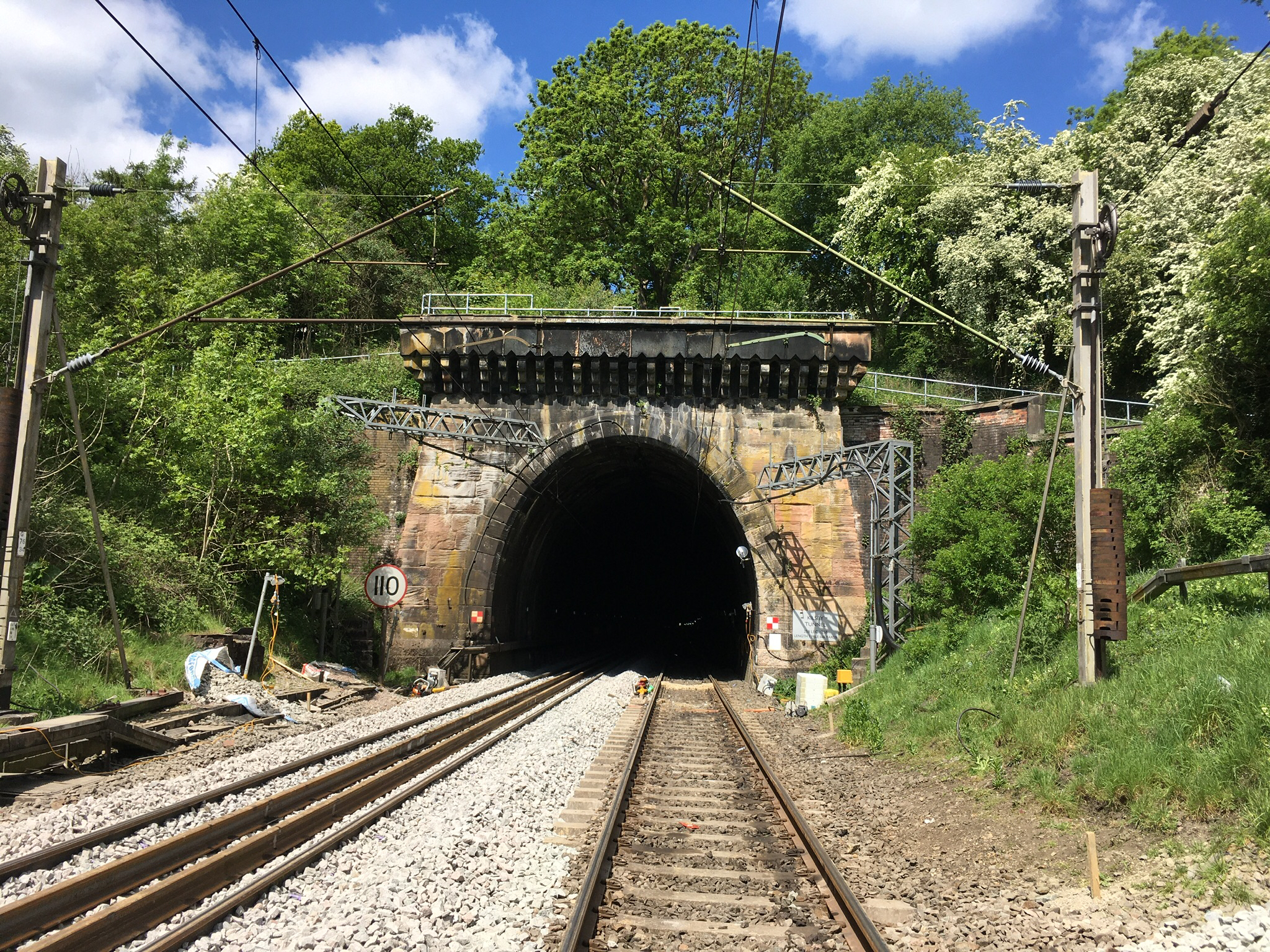

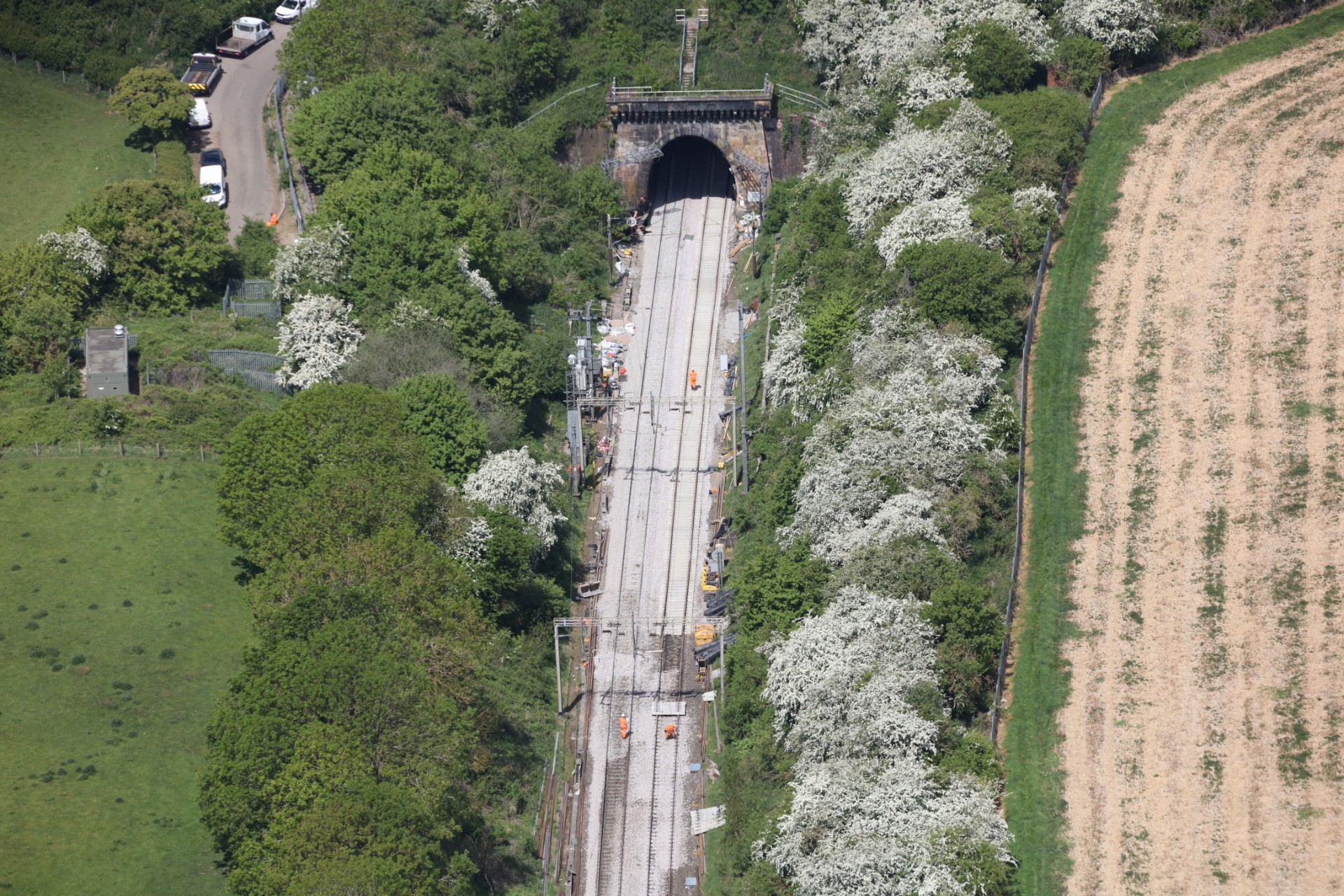

Kilsby Tunnel near Daventry reopened today (Monday 18 May) after major upgrades to drainage and track on a vital section of one of Europe’s busiest mixed-use passenger and freight railway lines.

It’s thought to be the longest full closure of the tunnel since it opened in 1837.

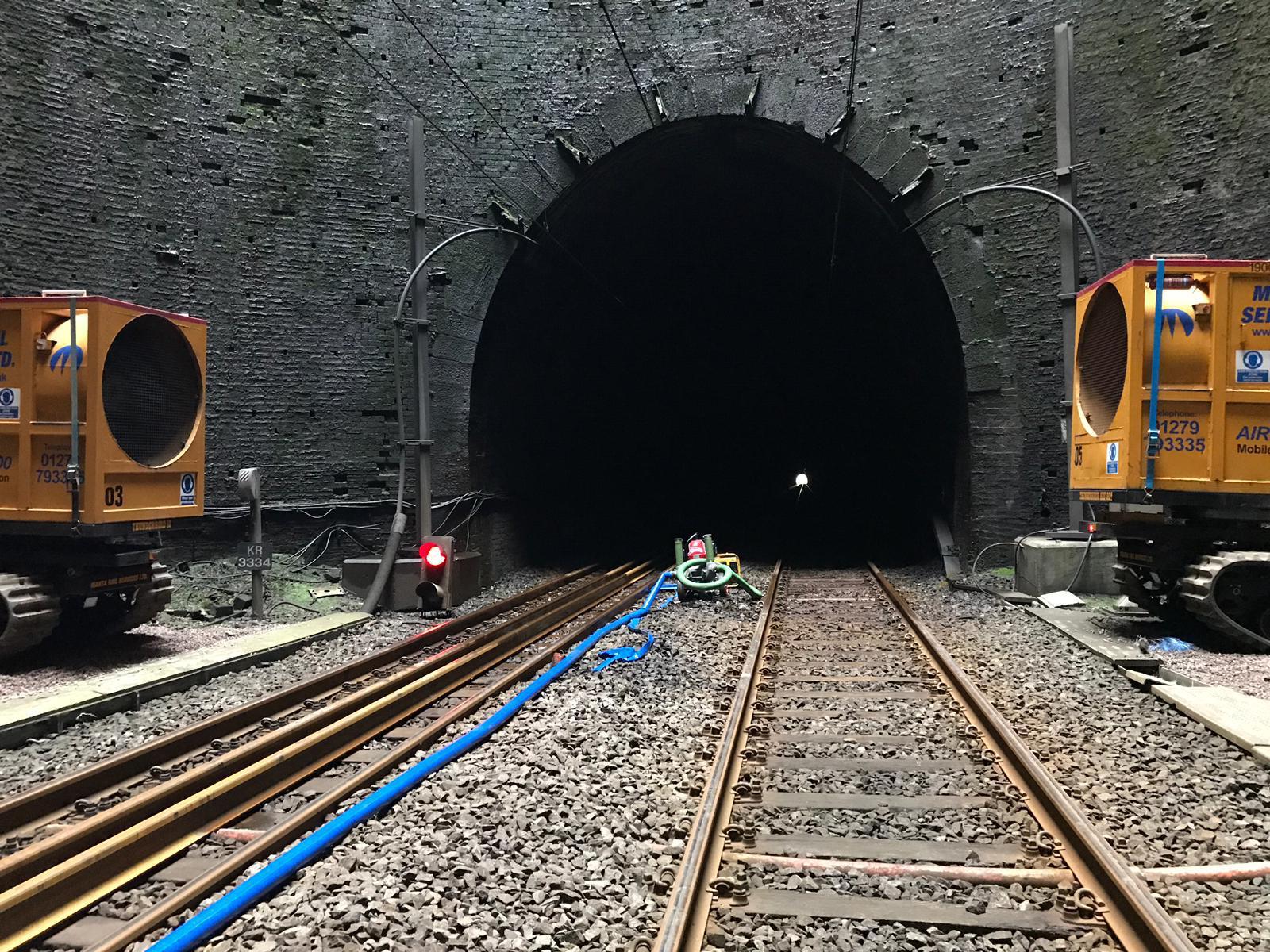

Because of its age water leaks through the 183-year-old tunnel’s walls had caused the track to flood and degrade.

Speed restrictions had to be imposed for the 400 trains which passed through it on average every day, causing delays to tens of thousands of passengers travelling between Euston and the Midlands.

Now the waterproofing and track drainage improvement work is complete, trains will be able to run through the tunnel at full line speed of 110 mph once again.

This will save Avanti West Coast services a total of 82 minutes in delays every day.

James Dean, Network Rail’s West Coast Mainline South director, said: “Bringing Kilsby tunnel up to modern standards will make a huge difference for passenger and freight trains on the economically important West Coast main line.

“In normal times it would have been impossible to close this entire section of railway for an upgrade of this scope and scale. I’d like to pay a huge credit to our train operators and industry colleagues for enabling us to carry out this work at short notice and get the railway in the best possible shape as the country recovers from the coronavirus pandemic.”

The Kilsby Tunnel project alone saw:

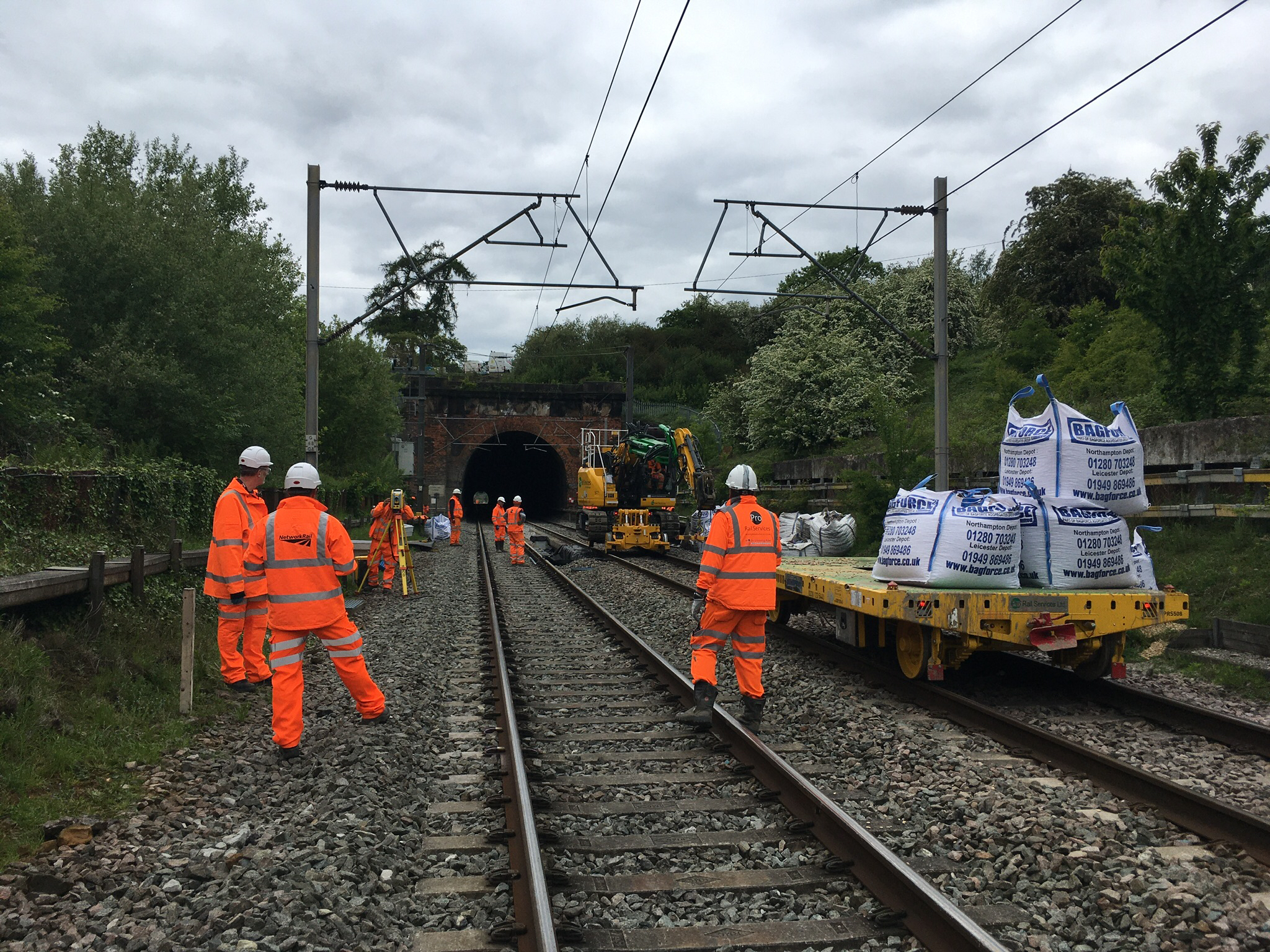

  • 1.3km of track replaced

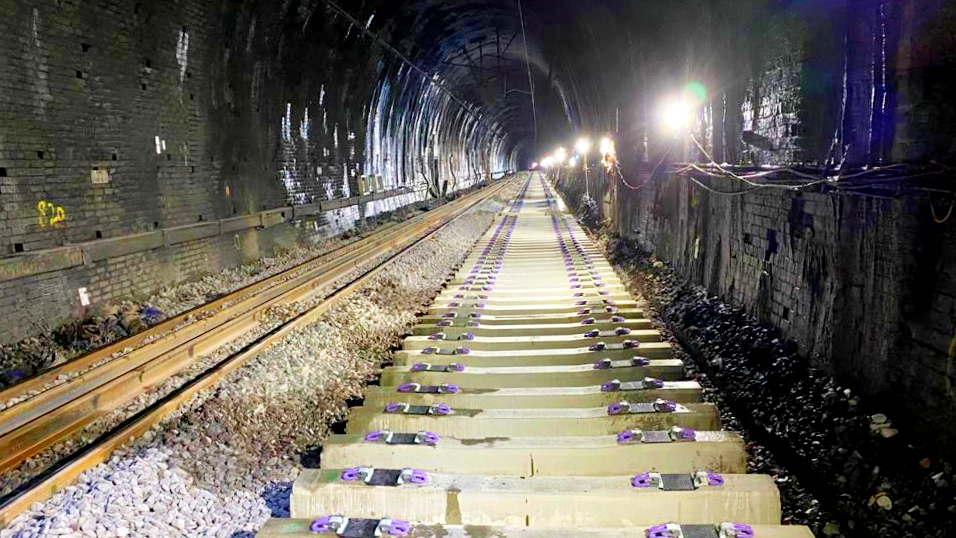

  • 2,458 new concrete sleepers laid

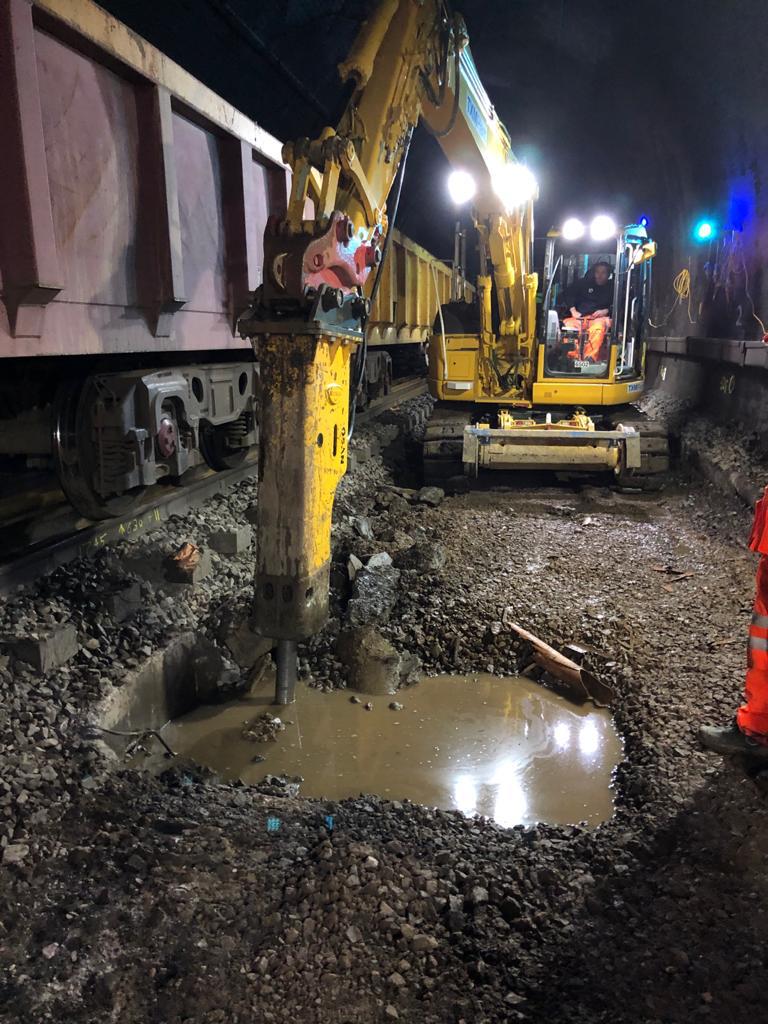

  • 7,700 tonnes of railway foundation stone (ballast) laid

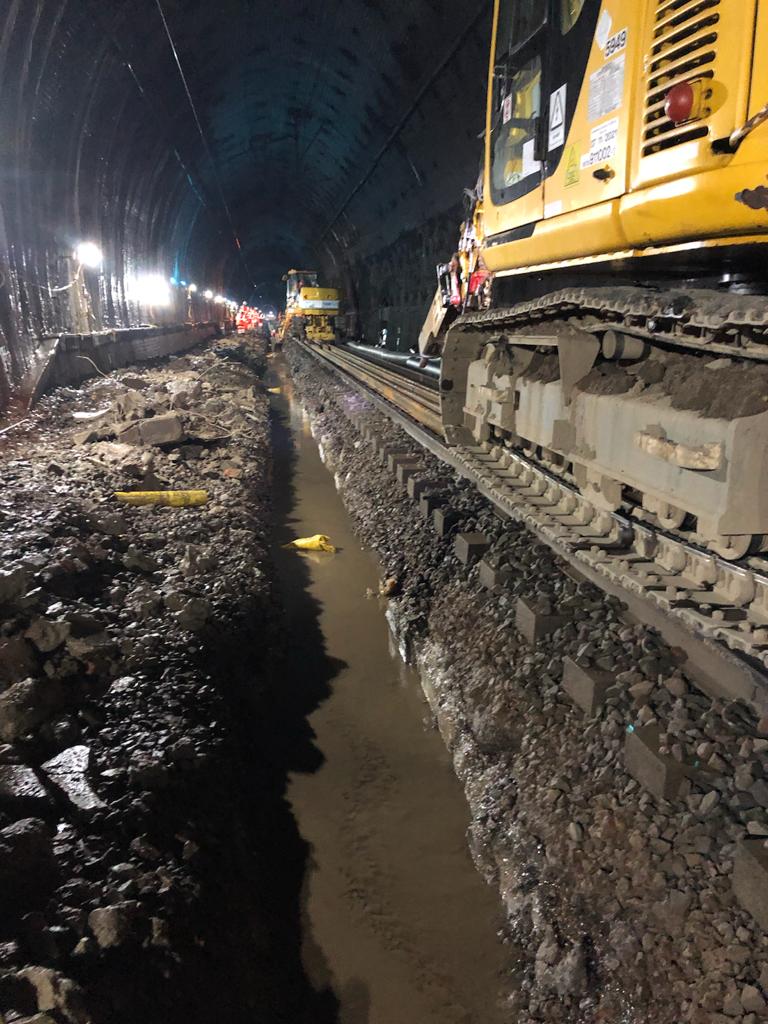

  • 745 metres of new drainage created
  • A total of 23,870 hours worked on the project

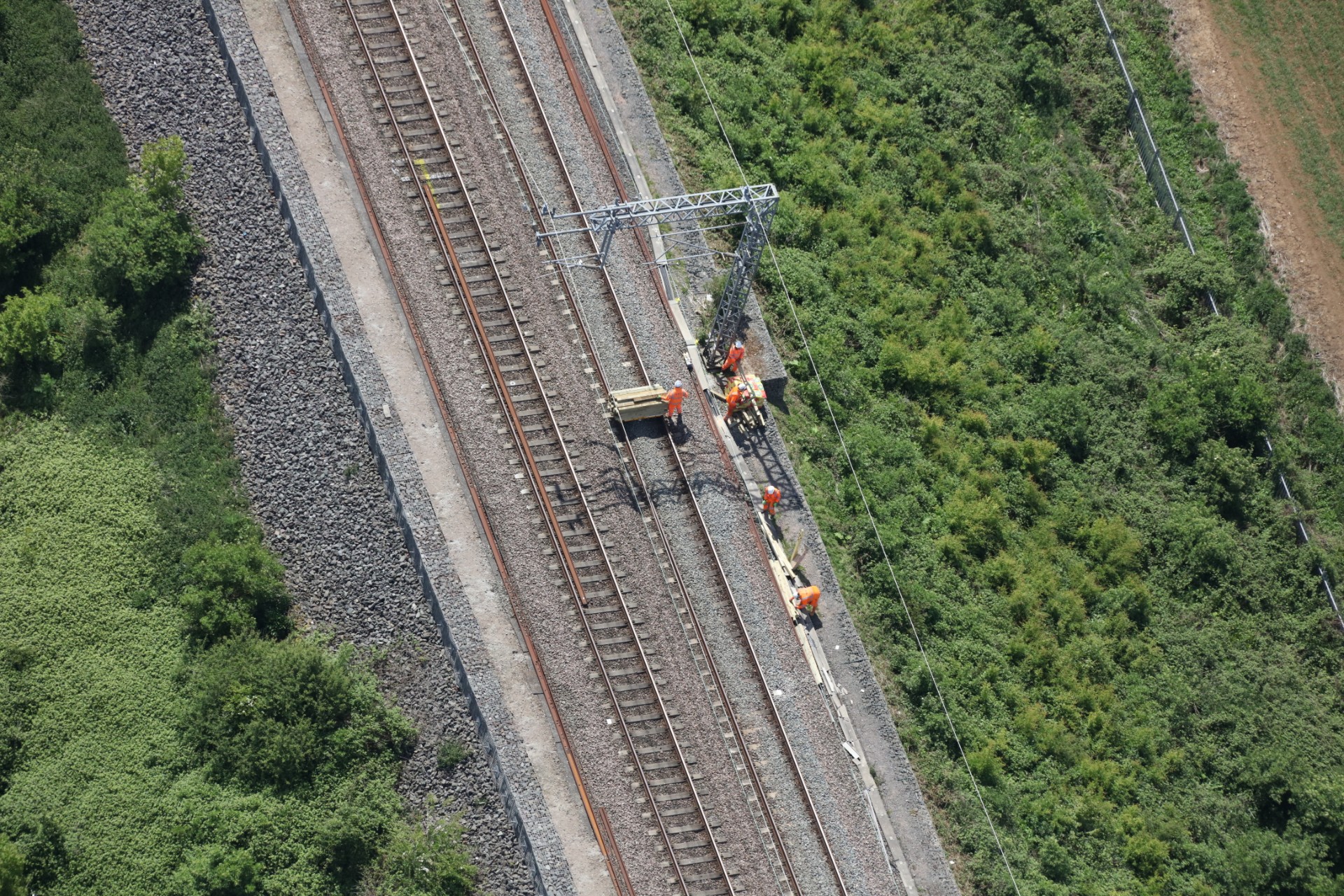

Network Rail agreed with train operators to carry out this work while fewer trains were running during the coronavirus slowdown.

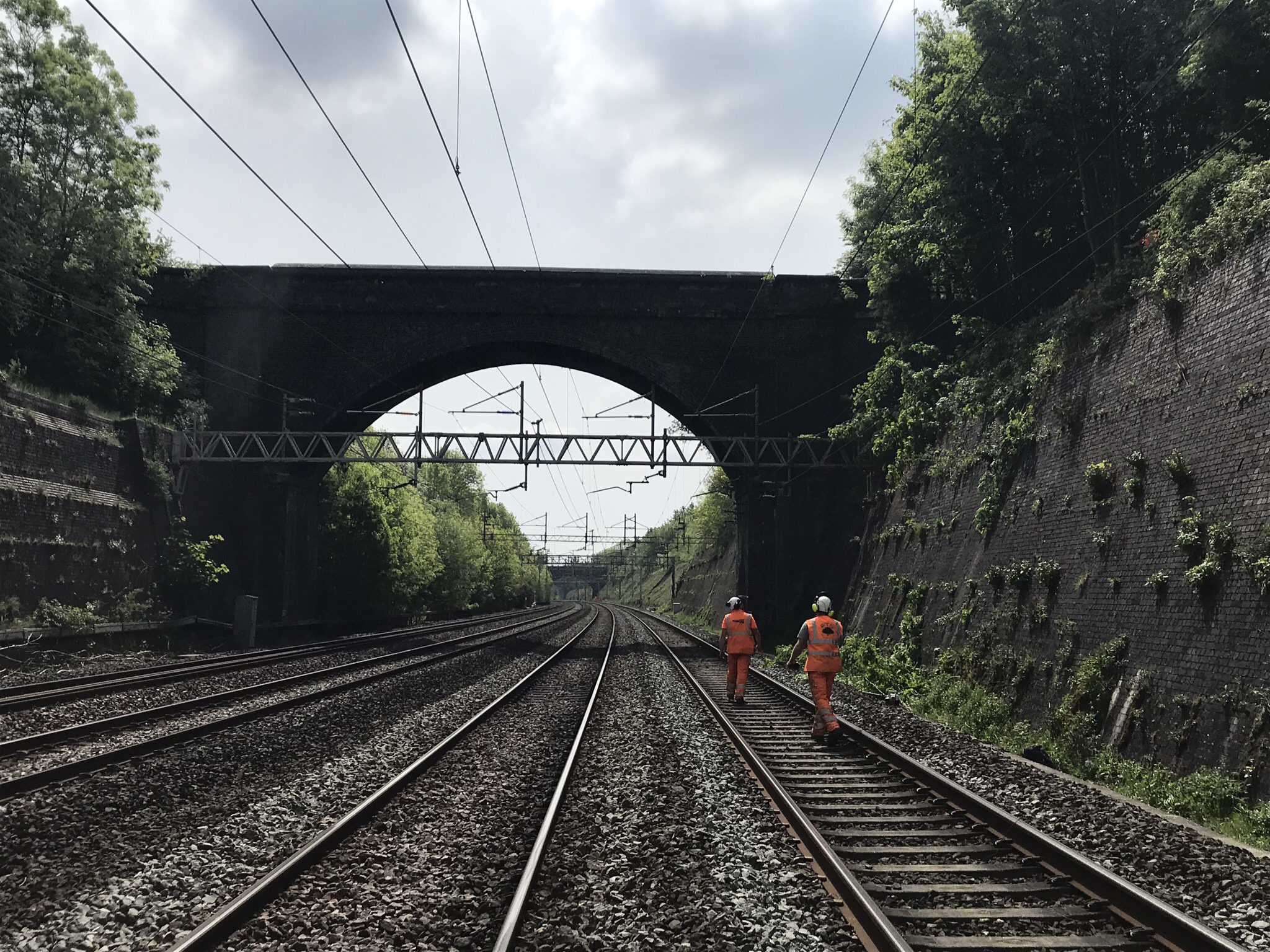

This enabled a total of 250 other jobs to be done on the closed section of railway between Rugby and Milton Keynes.

These included:

  • Replacing and maintaining signalling cabling and equipment
  • Maintaining the 25,000v overhead lines which power trains
  • Replacing and welding rail
  • Installing new railway sleepers
  • Improving trackside drainage
  • Inspecting railway structures
  • Managing overgrown lineside trees and plants

Gus Dunster, executive director of operations at Avanti West Coast, said: “We are pleased to have played an important role in giving Network Rail access to the railway between Rugby and Milton Keynes – a notoriously difficult section to maintain due to the number of trains that use it every day.

“This scale of work would usually take months of careful planning but working together with industry colleagues we were able to do this in a matter of days because of our reduced timetable and alliance with Network Rail. At the same time, we were able to protect our vital services for key workers, those making essential journeys and enable works to this treasured landmark to take place.

“It’s a great achievement in unprecedented circumstances and we would like to thank all of those involved for making this happen, and for the patience of everyone who has travelled with us over the last two weeks. The works will deliver a long-term benefit – improving reliability for millions of customers across the West Coast Main Line when we look forward to welcoming them back in the future.”

Meanwhile passengers are advised to follow the Government’s guidelines on the use of public transport during the coronavirus pandemic.

People should avoid travelling by train and only do so if they have to.

With train timetables changing from today, those who do need to travel are advised to check www.nationalrail.co.uk.

Notes to Editors

  • Kilsby Tunnel is around 1.5 miles long and is situated on the West Coast main line in Northamptonshire
  • The tunnel was built in the 1830s using an estimated 30 million bricks
  • On a normal weekday around 400 trains run through the tunnel on one of Europe's busiest mixed use (passenger and freight trains) stretches of railway
